What Are the Different Types of Metal Buildings?
Metal buildings sort into five structural systems — pre-engineered, cold-formed, conventional structural steel, arch, and hybrid. A sixth option, post-frame, gets quoted alongside them without being a metal building at...

- 1.What Counts as a Metal Building — and What Doesn’t
- 2.Main Types of Metal Buildings and Where Each Fits
- 3.How the Systems Compare on Span, Openings, and Engineering Scope
- 4.Which Variable Should Decide Your Building Type
- 5.What to Verify Before You Sign a Metal Building Quote
- 6.Locking In the Right Metal Building Type
- 7.Further Reading
Metal buildings sort into five structural systems — pre-engineered, cold-formed, conventional structural steel, arch, and hybrid. A sixth option, post-frame, gets quoted alongside them without being a metal building at all, and settling that distinction early saves a lot of confusion. The system you choose sets your clear span, your openings, and how much engineering the project carries. Start from the use case instead — “I need a workshop” — and you collect quotes built on different systems and different scopes, which cannot be compared line by line.
What Counts as a Metal Building — and What Doesn’t
“Metal building” is an everyday label, not a technical one, and the gap shows up once you start reading quotes. MBMA reports that the 2024 edition of the International Building Code introduced a definition for *metal building system*: an integrated set of manufacturer-designed components forming a complete or partial building shell. The description covers built-up primary framing, cold-formed or open-web secondary members, a metal panel roof, and exterior wall cladding, fabricated so the parts can be inspected before erection. Where the 2024 IBC has been adopted, that definition is the reference point.

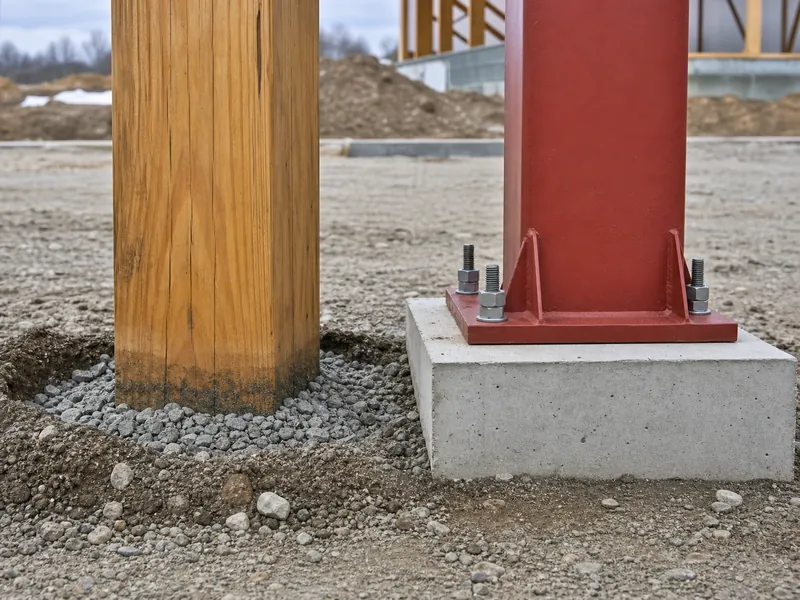

Post-frame buildings are a common source of confusion here. Sold as pole barns, they carry roof load on large wood columns embedded in the ground or set on piers, with steel appearing only in the fasteners and the skin. A post-frame shell can look identical to a steel-framed one from the parking lot and behave differently under snow load or a future crane addition.

Steel is an iron alloy holding under 2 percent carbon, which is why “steel building” and “metal building” get used interchangeably in the trade. Prefabricated metal buildings in the US market are essentially always steel.
This article stays at the system level. Frame geometry inside a system, foundation design, insulation assemblies, and permitting workflows each turn on their own variables and fall outside what follows.
Main Types of Metal Buildings and Where Each Fits
Start with the widest span you need to leave unobstructed, then check whether the system’s openings, loads, and engineering scope still work. Five of the six systems below are metal buildings. Post-frame appears because it gets quoted against them, and because it is not one.

Pre-Engineered Metal Buildings (PEMB)

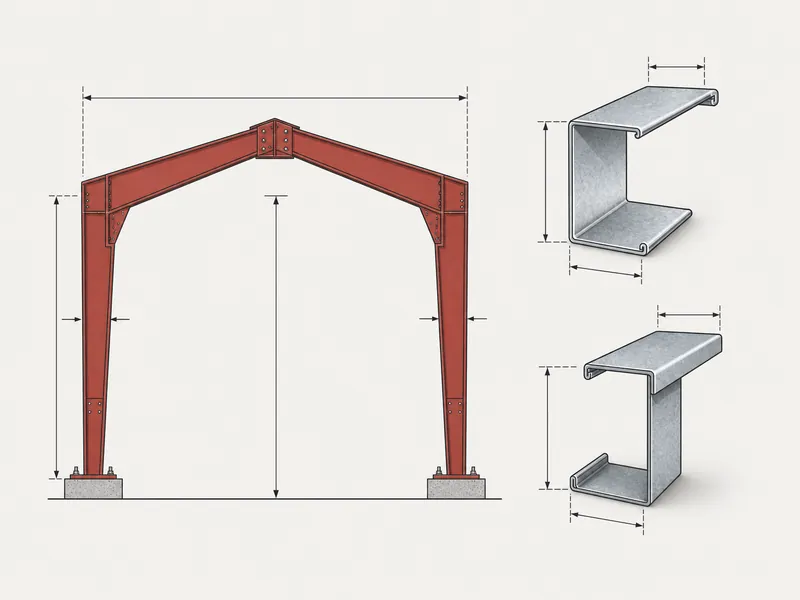

PEMBs use heavy hot-rolled steel columns and rafters — the “red iron” of the trade — factory-welded into tapered rigid frames and bolted together on site. Tapering each frame to its actual moment demand is what lets PEMBs reach the large clear spans that distribution centers, manufacturing plants, and steel airplane hangars need. Industrial metal buildings in this family can take crane rails, firewalls, and cold-storage envelopes. Each of those has to be written into the design criteria and the order documents to be part of the building. Where PEMBs stop making sense is at the small, simple end, where the engineering scope they carry has to be justified by the span you actually need.
Cold-Formed (Light-Gauge) Steel Buildings
Cold-formed systems roll thinner steel into C and Z sections instead of welding plate into frames, which shortens fabrication and lightens the structure. Workshops, small offices, and metal garage buildings sit comfortably in this range. Span and eave-height limits arrive earlier here than with a PEMB, so confirm the clear span, clear height, and design loads you need against a specific supplier’s product line. Published maximums vary enough between vendors that one company’s ceiling tells you nothing about another’s.
Conventional Structural Steel
Conventional steel means beams and columns fabricated to a project-specific design instead of to a manufacturer’s system. Multi-story frames, heavy crane loads, long irregular spans, and architectural shapes generally call for it, since they need more project-specific engineering than a packaged system is set up to deliver. The trade-off is scope. Conventional steel consumes more engineering calendar, and specifying it for a plain rectangular shell buys flexibility the building may never spend.
Arch (Quonset) Buildings
Arch buildings bolt curved corrugated panels into a self-supporting shell with no interior columns and no separate frame. Equipment storage, shelters, and cold-storage sheds suit them well. Openings are where arch buildings get ruled out. Framing a standard window or overhead door into a curved structural panel requires custom fabrication and flashing, so doors often end up confined to the flat end walls. The curve also takes usable floor area along both sides.

Post-Frame Buildings — Quoted Alongside, But Not a Metal Building
Post-frame carries load through wood columns set in the ground or on piers, with a conventional gable roof above and steel cladding outside. Barns, riding arenas, and farm storage are where it competes on cost at moderate spans, which is why agricultural steel buildings are worth pricing against it before you decide. The structure is still wood. Ground-contact columns, decay at the soil line, and limited capacity for a future crane or mezzanine are the trade-offs, and a steel skin does not change them.
Hybrid Systems
Hybrid construction combines a packaged system for the large-volume portion with conventional steel where the geometry gets complicated — an office block attached to a warehouse is the standard case. Retail, service centers, and other mixed-use commercial buildings often land here instead of in a single system. The risk sits at the interface, where two engineering scopes meet at one connection and responsibility gaps show up if nobody owns it explicitly.
How the Systems Compare on Span, Openings, and Engineering Scope
Compare the systems on what they are and what you have to check — not on price, lead time, or foundation. Those three move with span, loads, openings, engineering scope, and the individual supplier, so ranking them across the market would mislead more than it helps.
| System | Primary framing | Clear-span role | Main constraint to check | Where it usually lands |
|---|---|---|---|---|
| Pre-engineered (PEMB) | Hot-rolled tapered rigid frames, factory-welded | Large clear spans | Engineering scope justified by the span; crane, firewall or cold storage only if specified | Warehouses, plants, hangars |
| Cold-formed | Roll-formed C and Z sections | Moderate clear spans | Span and eave-height limits vary by supplier product line | Shops, garages, small offices |
| Conventional structural steel | Beams and columns fabricated per project | Large spans plus non-rectangular geometry | Carries more project-specific engineering scope | Multi-story, heavy crane, irregular shapes |
| Arch (Quonset) | Curved corrugated self-supporting panels | Moderate spans, no interior columns | Openings need custom fabrication; the curve costs floor area | Storage, shelters |
| Post-frame — not a metal building | Wood columns with steel cladding | Moderate spans | Wood structure; limited capacity for future loads | Barns, arenas, farm storage |
| Hybrid | Packaged system plus conventional steel | Varies by mix | Interface between two engineering scopes | Office-plus-warehouse combinations |

Published span and lead-time figures conflict across the industry enough that they should not drive a decision on their own. One supplier’s stated maximum width for cold-formed can sit well below another’s. Quoted lead times for the same system range from a few weeks to several months, depending on whether the number describes fabrication, delivery, or erection.
Price comparisons fail for a separate reason worth naming before you collect quotes. Per-square-foot figures circulate for kit-only material, for a shell including foundation and erection, and for a finished occupied building — three different scopes that can differ by a wide margin. Fix the scope definition first, then ask every supplier to price that same scope. A cheap number against an undefined scope tells you nothing.
Which Variable Should Decide Your Building Type
Lock your constraints in this order, because each one removes systems the next variable can no longer rescue:
- Widest unobstructed span. The largest distance you need without a column sets the system family before anything else does.
- Clear height under the frame. Crane hooks, racking, lifts, and door headroom are measured from the low steel, not the eave.
- Site loads. Snow, wind, and seismic demand at your actual address decide how much frame the span costs you.
- Openings. Door size and placement can rule out a system on their own, and they are cheap to settle on paper.
- Future expansion. An endwall extension, a mezzanine, or a crane added in year five is cheaper to design for now than to retrofit.
Budget belongs outside that list. A target price can be met by a building that misses the span, and that correction arrives later as re-engineering.
What to Verify Before You Sign a Metal Building Quote
Verify who owns the design loads before comparing anything else in the quote. MBMA’s *Common Industry Practices* describes the industry convention here. The manufacturer designs the system to the design criteria and loads written into the Order Documents. Determining local codes that fall outside those documents is not the manufacturer’s job, and identifying the applicable building codes, zoning rules, and design loads sits with the end customer. That document states convention, not a standard, and MBMA notes your Order or Contract Documents prevail wherever the two conflict.
That allocation has direct consequences for a quote:
- Design loads and code basis. Confirm the snow, wind, and seismic values and the code edition the quote was priced against. A lower assumed load is a cheaper building, not a better one.
- Scope of supply. Under the same industry practices, personnel doors, windows, overhead and hangar doors, translucent panels, and ventilators are provided only when expressly specified in the Order Documents. Absent from the order means absent from the truck.
- Sealed engineering data. Certification letters and design calculations are sealed by the manufacturer’s engineer registered in the project’s jurisdiction. Supplying sealed drawings does not make that engineer the Engineer of Record — somebody still has to hold that role.
- Foundation responsibility. Reactions come from the manufacturer. Confirm in writing who designs the foundation that resists them.
The door schedule is where this bites. A shell priced without the overhead doors reads as the low bid, and the gap only shows up when the drawings arrive — by which point the framed opening either exists or it doesn’t.
Locking In the Right Metal Building Type
Work by elimination. Your widest clear span removes the systems that cannot reach it; clear height, site loads, and door openings remove several more; what survives is a short list you can put against one scope. The use case — hangar, shop, or barn — then shapes the layout inside a system you have already justified. Reverse that order and you get quotes that cannot be compared.
Two questions are worth settling before any supplier gets involved: whether your span genuinely needs to be column-free, and who on your side owns the design loads and the code edition. As a metal building manufacturer, we can price several of these systems against the same scope — but only once that scope exists. Defining it is work that belongs to you and your design professional first.
Further Reading
- MBMA Design Resources — Metal Building Manufacturers Association / industry association. Describes what a metal building system comprises and notes that the 2024 Metal Building Systems Manual is aligned to the 2024 IBC and ASCE 7-22. Use it to identify the code and load standard your quote should reference; it is a design resource hub, not a buyer’s guide.
- MBMA Common Industry Practices (2021) — Metal Building Manufacturers Association / industry practice document. Sets out the responsibility split between manufacturer, builder, and end customer for design loads, scope of supply, and sealed engineering data. It states industry convention, not a standard, and MBMA notes your Order or Contract Documents prevail wherever the two conflict.
- Metal Construction News: Really Good News about Metal Buildings — industry publication, column by MBMA’s chairman. Gives the industry’s account of the metal building system definition added in the 2024 IBC. Published in 2022 ahead of that edition’s release, so treat it as MBMA’s description of the definition and not as the code text itself.
Pole barns are post-frame buildings, and the structure is wood, not steel. Wood columns embedded in the ground or set on piers carry the roof load, while steel appears only in the cladding and fasteners. The distinction matters for snow-load capacity, decay at the soil line, and whether a crane or mezzanine can be added later.
No — a metal building system is a manufacturer-designed package, and conventional structural steel is fabricated to a project-specific design. MBMA reports that the 2024 IBC describes the system as an integrated set of components: built-up primary framing, cold-formed or open-web secondary members, roof panels, and cladding, manufactured so they can be inspected before erection. Conventional steel carries no such packaging and is engineered per project.
Cold-formed steel handles typical workshop spans, provided the supplier’s limits clear your actual requirement. Ask for the span and eave-height ceilings in writing, quoted against your snow and wind loads rather than as general product claims. A quote that skips that step is priced on assumptions you have not seen.

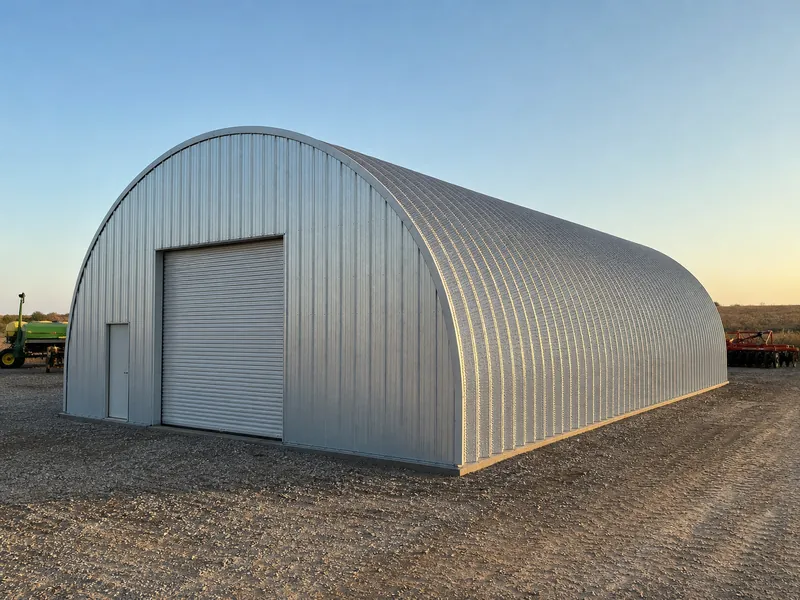

Openings in a Quonset’s curved sidewall require custom fabrication and flashing, so doors are usually placed in the flat end walls. Cutting into a structural corrugated panel means reinforcing what the cut removed, since the skin is the frame. If your layout needs sidewall doors, natural light along the length, or drive-through access, an arch building is likely the wrong system for the job.
Pre-engineered systems reach the large clear spans among the packaged options, with conventional structural steel available when the span or the geometry goes past them. Arch buildings are column-free too, over a narrower range and with the opening limits above. Confirm the span you need is truly unobstructed before paying for it — one permissible interior column can change which systems compete for the job.
