Commercial Construction Cost Per Square Foot
Commercial construction cost per square foot is not one number. It is a range. Scope drives it. Location drives it. Building type drives it. Finish level drives it. If you...

Commercial construction cost per square foot is not one number. It is a range. Scope drives it. Location drives it. Building type drives it. Finish level drives it. If you see $/sf as a fixed price, your budget will slip fast.
At Xinguangzheng, we build custom commercial metal buildings. We see where budgets go wrong first. Most problems start with unclear scope. The next problem is quotes that include different items. This guide helps you set the right cost boundary. It covers 2026 drivers. It helps you estimate a real range before bids.
Table of Contents
What Cost Per Square Foot Means?
Cost per square foot helps only when quotes use the same scope. One number may be shell only. Another may include full interior build-out. Then you compare different projects.
Shell vs build-out
A shell estimate covers the building structure. It covers the envelope. It covers basic site work. It covers structural work to stand the building up. For many commercial projects, shell can include steel framing. It can include roof panels. It can include wall panels. It can include doors. It can include windows. It can include basic foundation work. It often excludes tenant interiors.
Build-out spreads costs wide. Build-out can include partitions. It can include finishes. It can include plumbing fixtures. It can include specialty electrical. It can include lighting layouts. It can include fire protection details. It can include mechanical distribution for occupancy. A warehouse with little interior work differs from a retail store. It differs from a clinic.
Remember one rule. Ask every supplier to list inclusions next to their $/sf number. Ask them to list exclusions too. This step stops big misunderstandings.
Hard costs, soft costs, operating costs
Hard costs are physical construction items. They include the structure. They include the foundation. They include the envelope. They include major systems. Most $/sf talks focus here. It is the best spot to compare options.
Soft costs support the project. They do not become part of the building. They can include design. They can include engineering. They can include permitting. They can include inspections. They can include project management. Soft costs scale with complexity. They scale with local processes. They do not scale just with square footage.
Long-term operating costs sit outside build cost. But they matter. Better insulation cuts energy bills. Better air sealing cuts energy bills. Smarter HVAC controls cut energy bills. This may raise initial cost. But it can lower ownership cost over time.

Why ranges change between projects?
A $/sf figure is a budgeting tool. It is not a contract price. Two projects with the same area can differ. They can have different structural demands. They can have different schedules. They can have different code requirements. Use $/sf to build an early range. Tighten it as scope clears.
Treat early numbers as decision ranges. This keeps expectations real. Convert them to a component budget later. This makes your estimate strong.
Further Reading: How Much Does a Metal Building Cost?
The 2026 Cost Drivers That Move Your Budget
In 2026, big $/sf swings come from labor. They come from materials timing. They come from regulatory burden. These affect every construction method. They affect metal buildings too. Know these levers. Then explain why your project sits low, middle, or high in a range.

Materials and procurement timing
Materials pricing moves at different paces. Steel can shift with supply (~$912/ton). Concrete can shift with transport and fuel costs. Insulation can shift with demand. Lock design late, and you buy materials late. Late buys can cost more.
Procurement timing affects schedule risk. Lead times stretch, and you pay for acceleration. Acceleration shows as overtime. It shows as resequencing. It shows as premium freight. These costs are real. They may not appear as line items at first.
Labor, trade availability, productivity
Labor is a big part of commercial construction. Costs rise when skilled trades are scarce (e.g., electrician annual salary ~$61,590, shortages leading to 3.7% cost increase). Costs rise when schedules compress. Electricians become critical. Plumbers become critical. Mechanical crews become critical. This happens in buildings with high system complexity.
Productivity matters. A clean scope helps crews work fast. Coordinated drawings help crews work fast. Ambiguity creates rework. Rework costs a lot on a jobsite. Many mystery overruns are labor productivity losses.
Zip code effects
The same building costs differ in different markets. Major metros have higher wages. They have tighter logistics. They have pricier permitting. Coastal areas add structural requirements. They add code requirements for wind. They add requirements for seismic. They add requirements for energy.
Even in one state, downtown sites differ from suburban sites. Limited laydown space raises cost. Restricted delivery windows raise cost. Traffic control raises cost. A higher $/sf in urban markets often stacks factors.
Schedule pressure
A short schedule cuts time to occupancy. But it can raise cost. Fast schedules reduce sourcing flexibility. They force parallel work. They increase penalties for late decisions. Expect a premium for early occupancy. Unless you design for speed from day one.
Many owners consider pre-engineered approaches for this. Standardize design. Plan fabrication early. Then the project moves with few surprises. Speed comes from preparation. Not from crews working faster.
Permits and compliance
Permitting costs vary by area. Compliance costs vary by area. Requirements for fire protection change system scope. Requirements for accessibility change system scope. Requirements for energy performance change system scope. Requirements for structural loading change system scope. They influence design timeline. They influence inspection flow.
Compliance costs are not just permit fees. They include added design work. They include documentation. They include upgraded systems to pass inspections. In some markets, these drive cost more than materials.
Market risk and financing
Bid pricing reflects workload. It reflects risk. It reflects uncertainty. Busy contractors raise prices. Unclear scope raises risk. Pricing follows. Financing conditions influence total cost. Borrowing costs rise (interest rates 4.25-4.50% may drop to 3.75-4%). Lenders demand contingencies.
Separate build cost from financing cost for budgeting. But plan both. A well-designed project can feel expensive if capital costs high.
Further Reading: How Much Does a Metal Building Cost?
Cost Ranges by Method and Building Type
Your $/sf range comes from two choices. How you build. What you build. Construction method sets the structural path. It sets the delivery path. Building type sets system complexity. It sets finish expectations. Put these together before quotes.
| Construction method | Typical fit | Cost behavior | Budget notes |
|---|---|---|---|
| PEMB (pre-engineered metal building) | Low-rise commercial shells, warehouses, light industrial | Often efficient for shell + predictable fabrication | Costs widen with higher finishes and complex MEP |
| Light-gauge steel stud framing | Interior flexibility, partitions, fit-outs | Sensitive to labor and finish scope | Great for interiors, not a “cheap by default” path |
| Structural steel framing | Multi-story or complex geometry | Higher fabrication and coordination demands | More design freedom, but more variables |
| Tilt-up construction | Large footprints (warehouses, retail boxes) | Fast walls, crane-heavy workflow | Site logistics and schedule timing matter |
| Finish level (all methods) | Low / mid / high finish | Biggest driver of total variance | Finish scope must be defined early |
PEMB: efficient low-rise shells
PEMB works best for low-rise projects. It works when owners want a clean shell. It works with a predictable structural system. It shortens design to fabrication when scope is stable. It supports clear-span interiors. This maximizes usable floor area.
PEMB does not erase interior costs. Dense MEP systems add cost. Specialty rooms add cost. High-end interiors add cost. Build-out can dominate the budget. The method helps most with a straightforward shell. It helps with an efficient fit-out.
Light-gauge framing: interior flexibility
Light-gauge steel framing is common for interior partitions. It is common for commercial fit-outs. It supports flexible layouts. It makes future changes easier. It integrates with typical interior wall assemblies.
Its costs depend on labor. They depend on finish scope. Many rooms raise cost. Complex details raise cost. Premium finishes raise cost. Framing is not the main driver. The details attached to it are.
Structural steel: complex and multi-story
Structural steel framing fits multi-story needs. It fits larger column grids. It fits architectural requirements beyond standard systems. It supports complex solutions. It supports unique layouts. It allows flexibility when use evolves.
Costs rise with on-site complexity. Field welding becomes critical. Coordination becomes critical. Schedule interfaces become critical. Invest early in coordinated design. Invest in clear fabrication packages.
Tilt-up construction: fast walls for large footprints
Tilt-up is used for large warehouses. It is used for distribution spaces. It is used for some retail shells. Cast wall panels on site. Lift them into place. This can save time in right conditions. The method needs good site access. It needs predictable sequencing.
Tilt-up is a workflow choice. Not just a wall choice. Crane time shapes the outcome. Panel curing schedules shape it. Site constraints shape it. Tight sites raise cost. Limited schedule windows raise cost.
Tilt-up: large footprints and fast wall cycles
Finish level drives cost spread. A basic warehouse interior differs from retail. Medical environments are system-dense. Lab environments are compliance-heavy. Define finish level early for a reliable budget.
Define finish level in plain language. Use “basic functional.” Use “standard commercial.” Use “premium customer-facing.” This is clearer than “nice.” Clear language cuts assumptions in bids.
Building type bands (directional)
Building types carry different system loads. They carry different code demands. Offices have higher HVAC expectations. They have higher interior finish expectations than shells. Hospitality adds bathrooms. It adds circulation. It adds finishes. Healthcare adds compliance. It adds specialized systems. Warehouses can be basic. Or complex with production. Or with cold storage. Or with high power needs.
| Building type | Typical range ($/sf) | Why it trends this way |
|---|---|---|
| Office | $240–$1,000 (average $560; single-story $240–$440, multi-story higher, affected by HVAC) | Higher finishes + HVAC expectations |
| Warehouse / light industrial | $140–$300 (average $214; basic shell $14–$22, but full build-out $210–$275) | Wide spread based on build-out and power needs |
| Retail | $120–$580 (average $300; shopping centers $370–$580, affected by tenant build-out average $155) | Customer-facing finishes and layout complexity |
| Hospitality | $130–$691 (average $478; three-star $180–$260, five-star $330–$550, affected by kitchen equipment increase 20-30%) | Bathrooms, finishes, circulation, life safety scope |
| Healthcare | $375–$1,020 (average $635; medical offices $375–$1,018, hospitals $450–$1,020, affected by regulations increase 20%) | Compliance + specialized systems |
| Education / public | $300–$840 (average $340; schools $300–$380, specialized facilities $700–$840, affected by safety systems) | Program requirements and durable finishes |
| Parking structures | $70–$210 (average $143; structure-heavy, low interior finish) | Structure-heavy, low interior finish |
These are directional ranges, affected by height (low-rise lower, mid/high-rise higher) and region. High-end markets (e.g., California) can increase by 70%.
Height also changes behavior. Low-rise projects usually have simpler structure and fewer vertical systems. Mid-rise and high-rise designs add structural demand, life safety coordination, and vertical transportation.
Regional Cost Snapshot and How to Read It (US)
Use regional ranges to check quotes. Not to predict exact prices. Test if a bid fits your market. Test if it fits your building type. Tighten the estimate with project inputs.
Typical regional patterns
East Coast markets trend higher (e.g., New York $350–$870). West Coast markets trend higher (e.g., San Francisco $380–$850). Labor drives this. Logistics drive this. Regulations drive this. Midwest markets show moderate costs (e.g., Chicago $180–$400). This fits straightforward shells. Southern markets can compete (e.g., Dallas $180–$400). But fast-growth metros may rise with demand.
The label matters less. Wages matter. Trade availability matters. Code requirements matter. Site constraints matter.
Why some metros price higher
High-cost metros stack constraints. Deliveries are hard. Storage is limited. Labor costs more. Permitting is slower. It is more document-heavy. A tight schedule grows the premium.
Owners try value engineering late under pressure. Late changes cost more than early planning. Address regional premiums with early scope clarity. Use early design coordination.
Climate and ground conditions
Climate changes structure needs. It changes foundation needs. Snow load drives roof design. Seismic requirements drive detailing in regions. Soil conditions drive foundation design. They drive site work. Wind exposure shapes envelope. It shapes structural decisions. These factors can increase structural costs by 10-20%.
These factors change hidden parts. They change structure insides. They change under the slab. Two buildings look equal on paper. But they price different in reality.
How to compare bids fairly
Standardize scope first when comparing bids. Align inclusions. Align exclusions. Align finish level. Compare in a table. Or a checklist. Not in a paragraph. If bids differ wide, ask for component breakdown. See where the difference is.
A good comparison shows hidden assumptions. This leads to a trusted budget fast.

How to Estimate Your Project More Accurately?

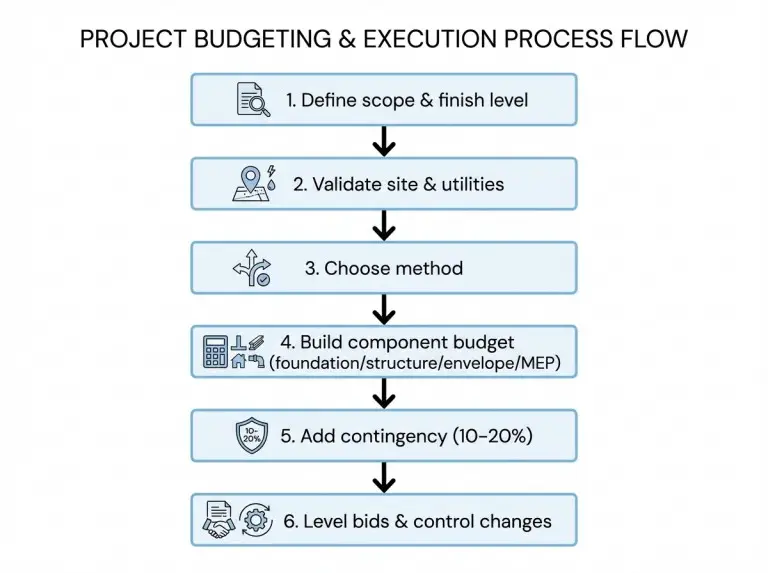

A reliable $/sf estimate comes from scope-first workflow. Not from chasing averages. Follow these steps. Your early range narrows. Your bids compare easier.
Step 1: Define scope, finish, performance targets
Start with building purpose. Start with occupancy needs. Define shell-only or full build-out. Define finish level in practical terms. Note premium finishes early. Note heavy power early. Note special rooms early.
Define performance targets that affect cost. Include thermal performance. Include door sizes. Include clear heights. Include special load requirements. These help designers. They help contractors. They avoid pricing guesswork.
Step 2: Validate site and utilities early
Site costs can swing budgets. Confirm soil conditions. Confirm drainage. Confirm access constraints. Validate utility availability. Validate capacity. Upgrades can become major items.
Early site clarity cuts schedule risk. Many budget surprises are site surprises. A small up-front check prevents big downstream costs.
Step 3: Choose the method that fits the use case
Select structural approach based on functional needs. Base it on delivery priorities. Favor methods for early fabrication if speed matters. Favor them for clean sequencing. Choose for flexibility if that matters more. Choose for multi-story if that matters more.
Many owners lose time here. They ask quotes before choosing method. This creates mixed pricing. It delays decisions.
Step 4: Build a component budget
Pick a method. Then build estimate as components. Break budget into foundation. Into structure. Into envelope. Into major systems. Add allowances for partitions if build-out included. Add for finishes.
This shows what drives cost. If MEP dominates, focus there. If envelope dominates from high-performance, evaluate options.
Step 5: Add contingency and escalation logic
Add contingency based on scope maturity. Early budgets need 10–20%. Higher for complex projects. As design firms up, reduce it. Do not skip this in 2026 markets.
Add escalation if lead times long. Or pricing volatile. Lock procurement earlier. Do not predict every change. Protect from known uncertainty.
Step 6: Cost-control moves that actually work
Control cost by cutting complexity. Keep building shape simple. Standardize bay spacing. Standardize openings. Avoid late changes. They disrupt fabrication. They disrupt sequencing.
Use scope leveling for bids. Give same scope notes to bidders. Require same inclusion format. Require exclusion format. This cuts hidden scope gaps. They become change orders later.
Plan for expandability early if metal building. Use expandable end walls. Use clean structural logic. This reduces future disruption. Expansion costs less when designed in.

Conclusion
Commercial construction cost per square foot is useful as a scoped range. It must be comparable. Lock your boundary first. Shell vs build-out. Hard vs soft costs. Map your project to 2026 drivers. Labor. Materials timing. Location constraints. Schedule pressure. Compliance.
Choose a method that fits the use case. Convert ranges to component budget. Add real contingency. Compare bids with leveled scope. Avoid comparing different projects. At Xinguangzheng, this workflow turns $/sf into an actionable budget.
Not always. Assume it does not unless written. Many $/sf figures mean shell and core. Interior build-out depends on tenant needs. It depends on finish level. Require a clear list before comparing.
Scopes are rarely identical. One quote may include site work. It may include upgraded systems. It may include higher finishes. Another excludes them. Differences come from schedule assumptions. From local labor rates. From risk pricing.
No. But they can be efficient for standardized low-rise shells. Structure may be efficient. But interior build-out can dominate. MEP can dominate. Metal economics work best with clear scope. With controlled complexity.
For early budgets, 10–20% is common. Higher for complex projects. Higher for fast-track. As design firms, contingency reduces. Keep higher if lead times high. Or pricing volatile. For complex or fast-track projects, it can reach 20-30%, due to 2026 labor shortages and material fluctuations.
It depends on scope maturity. On permitting. On system complexity. Not just square footage. Simple shells move quick with early locked design. Complex interiors take longer. Dense MEP takes longer. Long permitting takes longer.
James
James is a senior steel construction expert at Xinguangzheng, specializing in solutions for industrial and commercial projects. He has extensive project management and design experience and shares insights on sustainable building and steel structure innovations by writing articles.
Founded in 1997, Xinguangzheng Steel Structure Group has over 29 years of professional experience in the steel structure industry. We have completed more than 5,000 projects in over 130 countries and hold international certifications such as EN1090 (CE) and ISO9001. Whether it is a complex industrial building or a large commercial facility, Xinguangzheng always provides high quality and reliable steel structure solutions.
Related Articles
CostNeed A Custom Steel Building Solution?
Get a free quote from our engineering team — projects delivered to 130+ countries worldwide.
Price Your Steel Building →
